IceCube Upgrade!

Drill equipment staged at the SES
The seasonal equipment site (SES) (AKA "drill camp") staged at the future drilling site at the end of the 2023-24
season. In the foreground are the main heating plants...other stuff here are three generators, tanks, pump, and fuel
equipment. The IceCube Laboratory (ICL) is in the background. All photos are by Kurt Studt unless indicated otherwise.

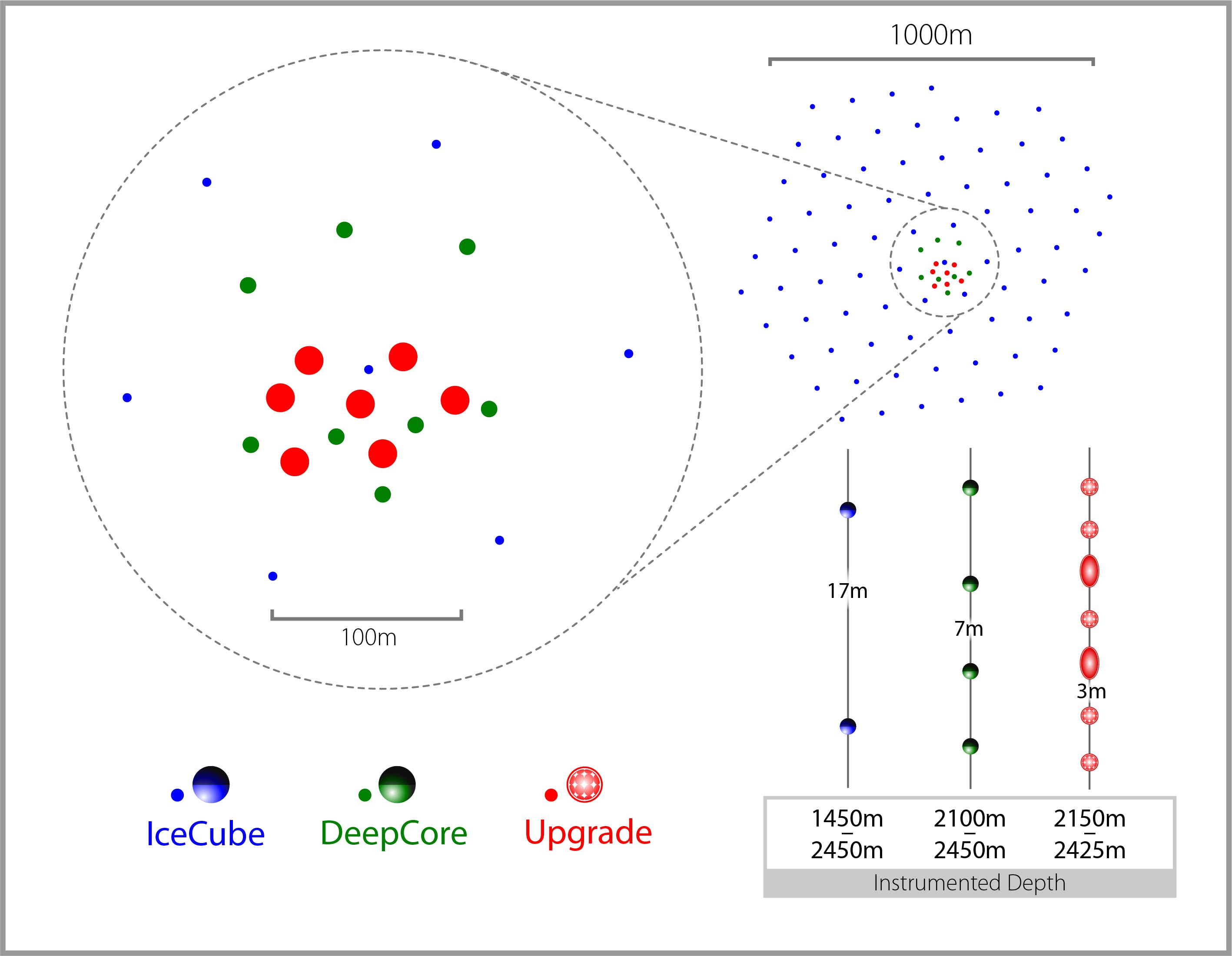

upgrade hole layout


The IceCube Upgrade is the first phase of a significant project upgrade, IceCube-Gen2. The Upgrade was originally approved by NSF in 2019, with completion planned for 2024, but of course the pandemic intervened. The Upgrade will add 7 new strings (red dots in the image at right) with 750 detectors, near the center of the existing string array. Drilling and installation is now scheduled for the 2025-26 austral summer season. The new strings will include 3 new types of optical modules and they will be spaced only 3m apart, compared to the 17m spacing of the digital optical modules (DOMs) in the original 80 strings. The new modules are depicted below:

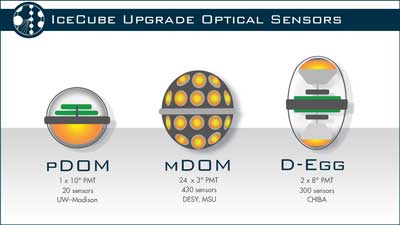

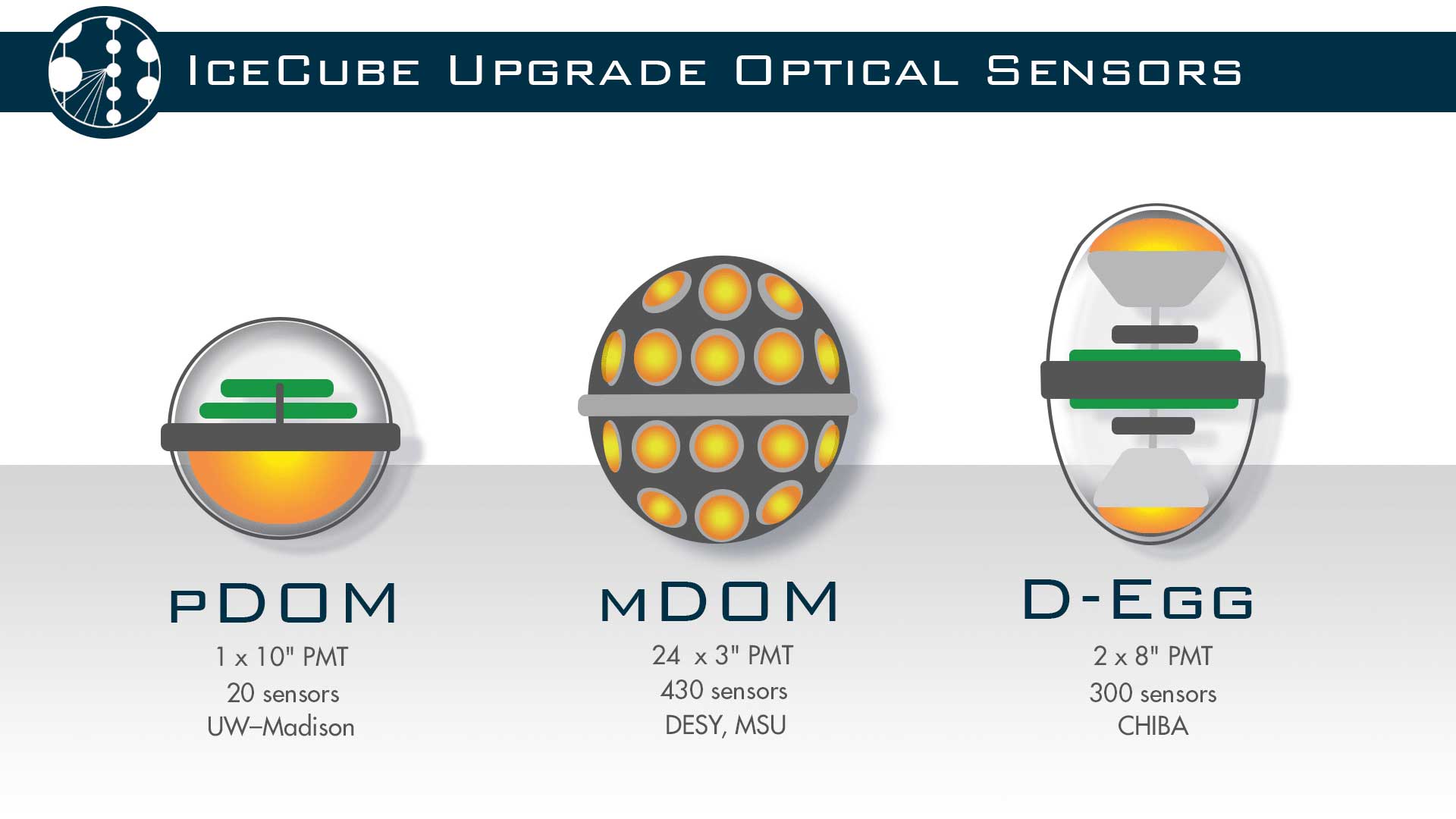

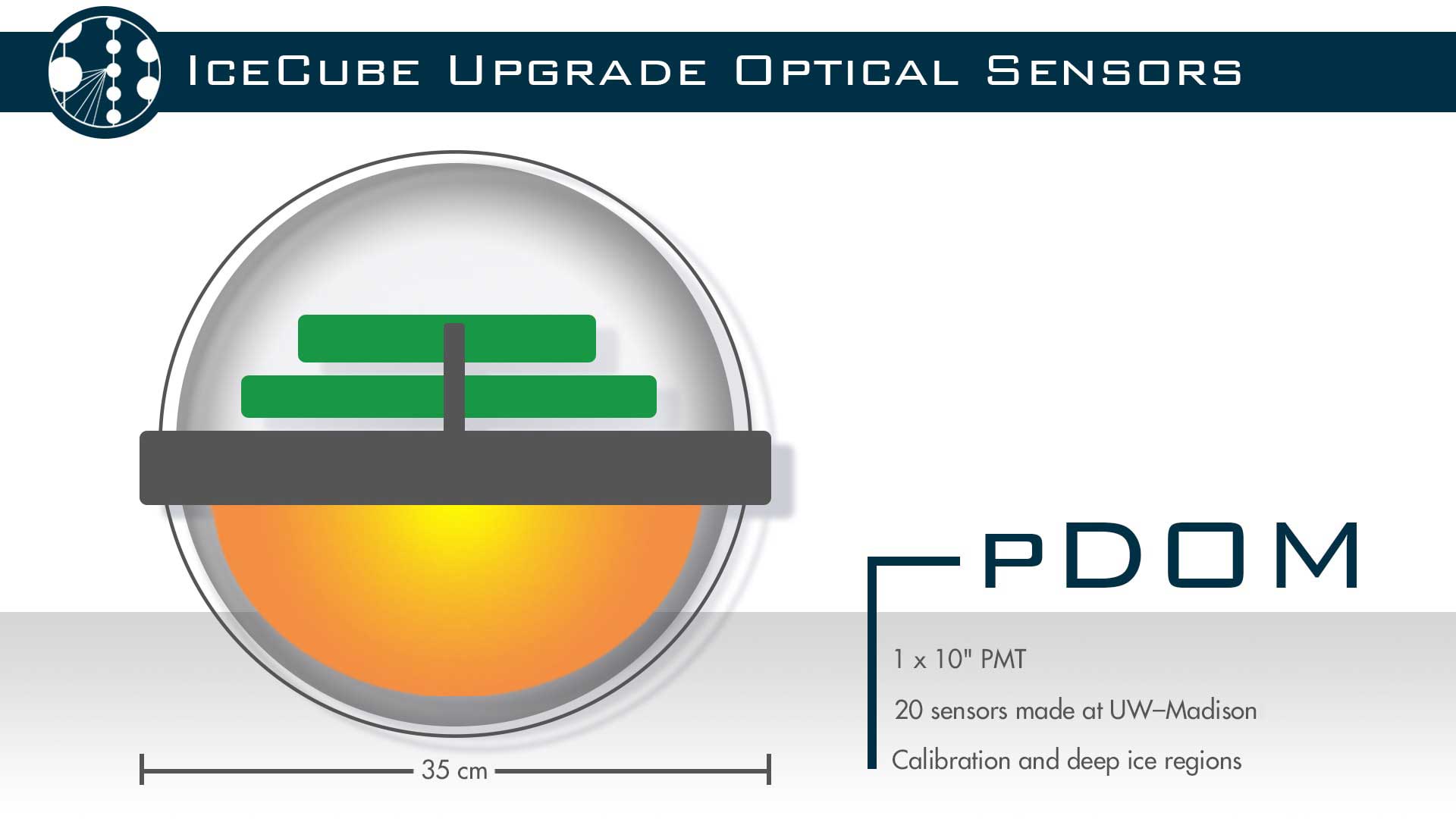

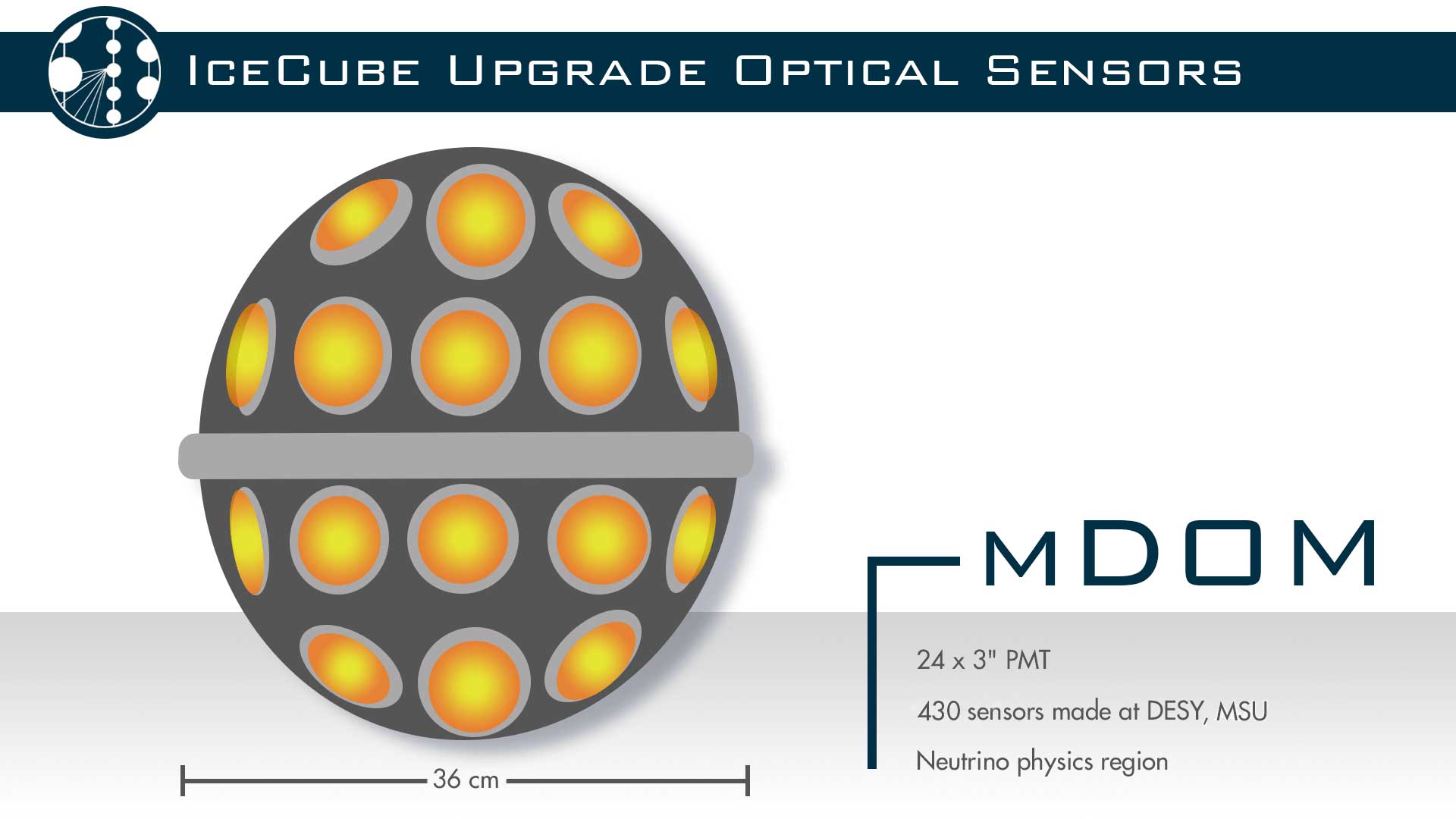

new IceCube sensors

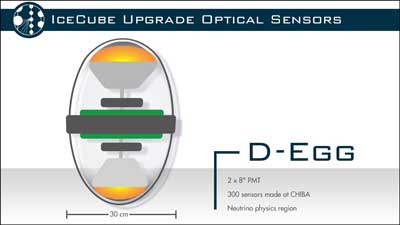

The 3 different types of optical sensors.

The above 5 images are from this press release image page which includes additional images and video (from this July 2019 press release). More clarifications...a PMT is a photomultiplier tube...these were components of the original DOMs. As for other listed developers/producers of the modules, DESY is the Deutsches Elektronen-Synchrotron in Germany, MSU is Michigan State University, and CHIBA is Chiba University in Japan (mentioned on this page).

Other than some preliminary inspections in 2022-23, 2023-24 saw the first significant field work in preparation for installing the new strings. Perhaps 20+ folks including winterovers and ASC personnel were involved...many people were from Wisconsin's Physical Science Laboratory (PSL). The group included team members from Sweden, New Zealand, and Thailand. All of their required cargo, including one of the generator modules, arrived on the first South Pole Traverse on 13 December. The first task was to move many of the modules and other equipment to a test site adjacent to the Cryo building.

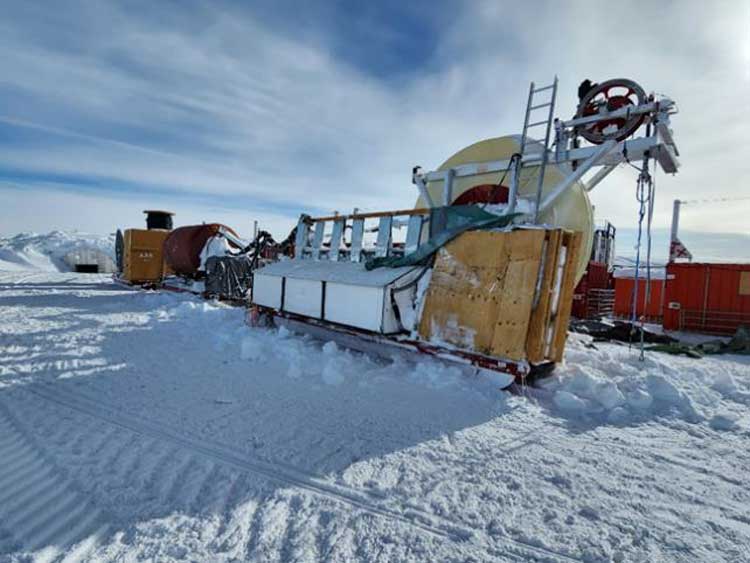

The ARA drill
The ARA Drill (Antarctic Rodwell Assembly aka Askaryan Radio Array drill) being towed toward the Cryo test site.
IceCube units by Cryo
One of the tower operations sites (TOS2) positioned over a trench at the test site. These facilities will be used to control the lowering of the sensor strings.

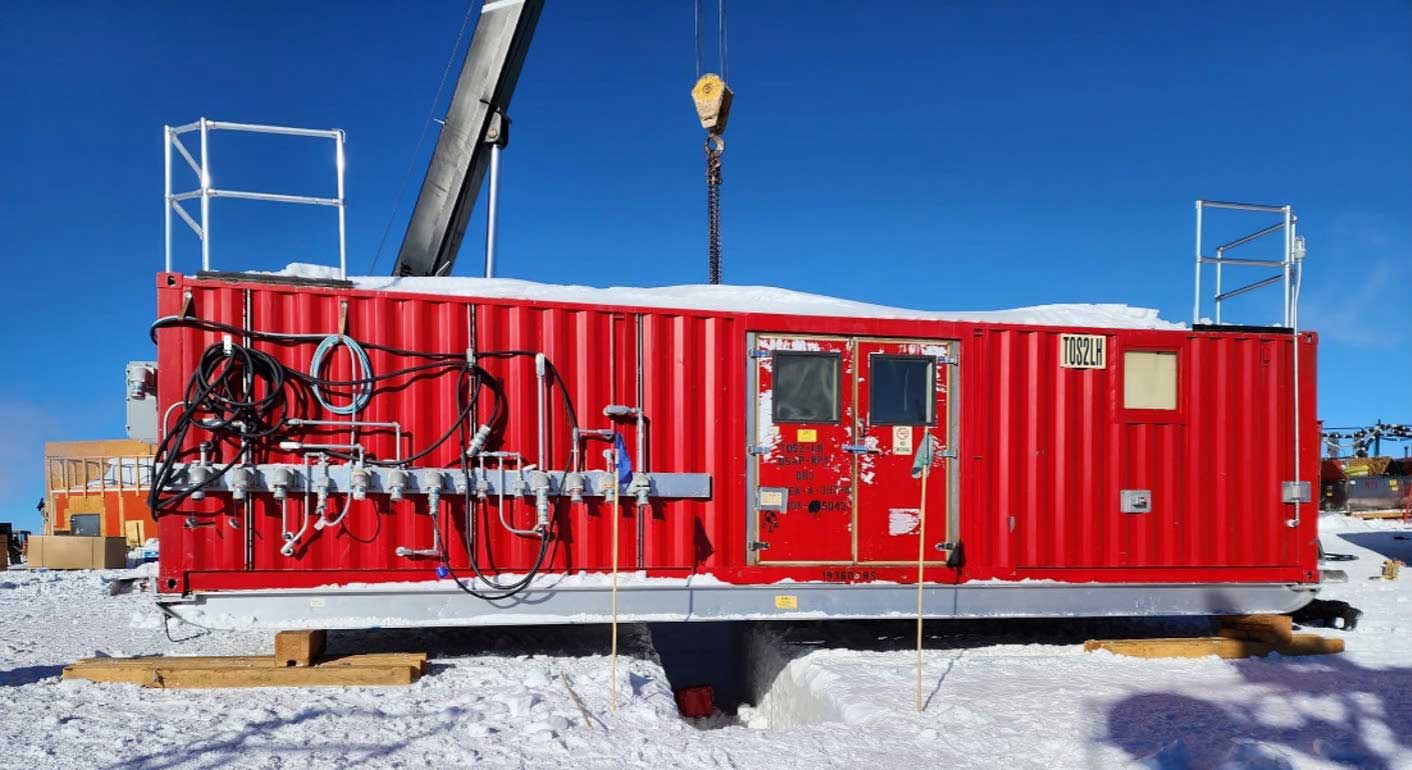

Tower Operations Site 2

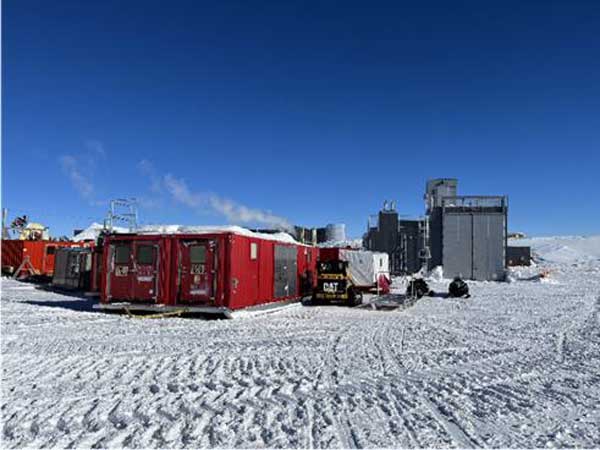

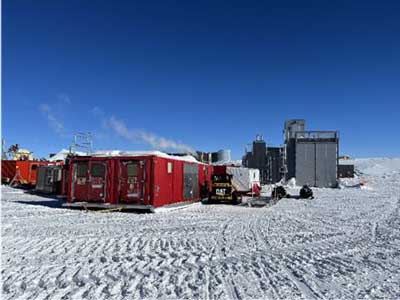

By mid-December, many of the modules including the generators were set up for tweaking and testing near Cryo/BIF (which can be seen at right) (KS).
IceCube units by Cryo
Another December view of IceCube modules at the test site by Cryo (Sheryl Seagraves).

Two drills are used to create the Rodriguez well (what is a Rodriguez well?) that will provide water for the hot water drills that are used to create the holes for the sensor strings...a firn drill ("carrot") used to drill through the surface snow layer...about 40m, and the ARA Drill (Antarctic Rodwell Assembly aka Askaryan Radio Array drill) used for the remaining depth:

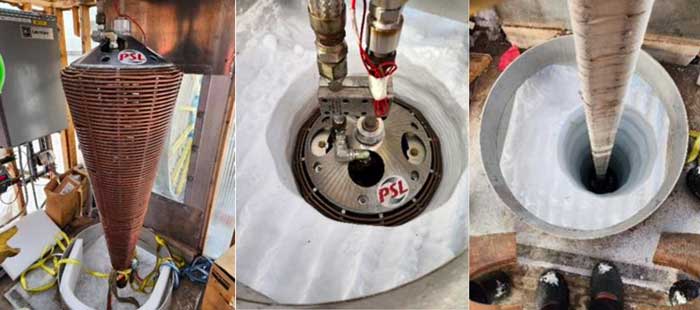

the firn drill
Above, a composite of the firn drill during its initial operation at the Cryo test site. It is . I remember it hanging around in the Rodwell buildings. Both of the drills are needed to create a Rodriguez well to provide water for the hot water IceCube drills ...and both drills were used this season to create an "Intermediate Sewer" for the station...to be used if the current sewer (formerly Rodwell 2) fills up.

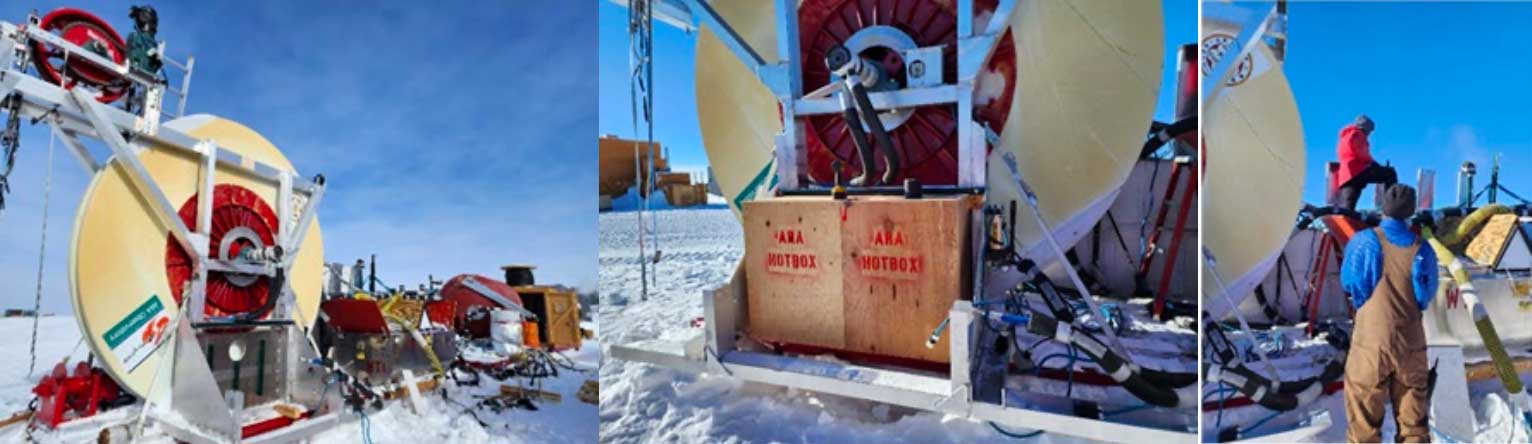

the ARA drill assembly being tested
A composite of the ARA drill assembly and insulated "hotbox" (plumbing manifold) being assembled for testing at the test site. This drill is used to complete the Rodwell...putting together and checking out the large hot water drill assemblies used for the actual IceCube string drilling and installation will be a project for 2024-25.

drilling a temporary sewer outfall

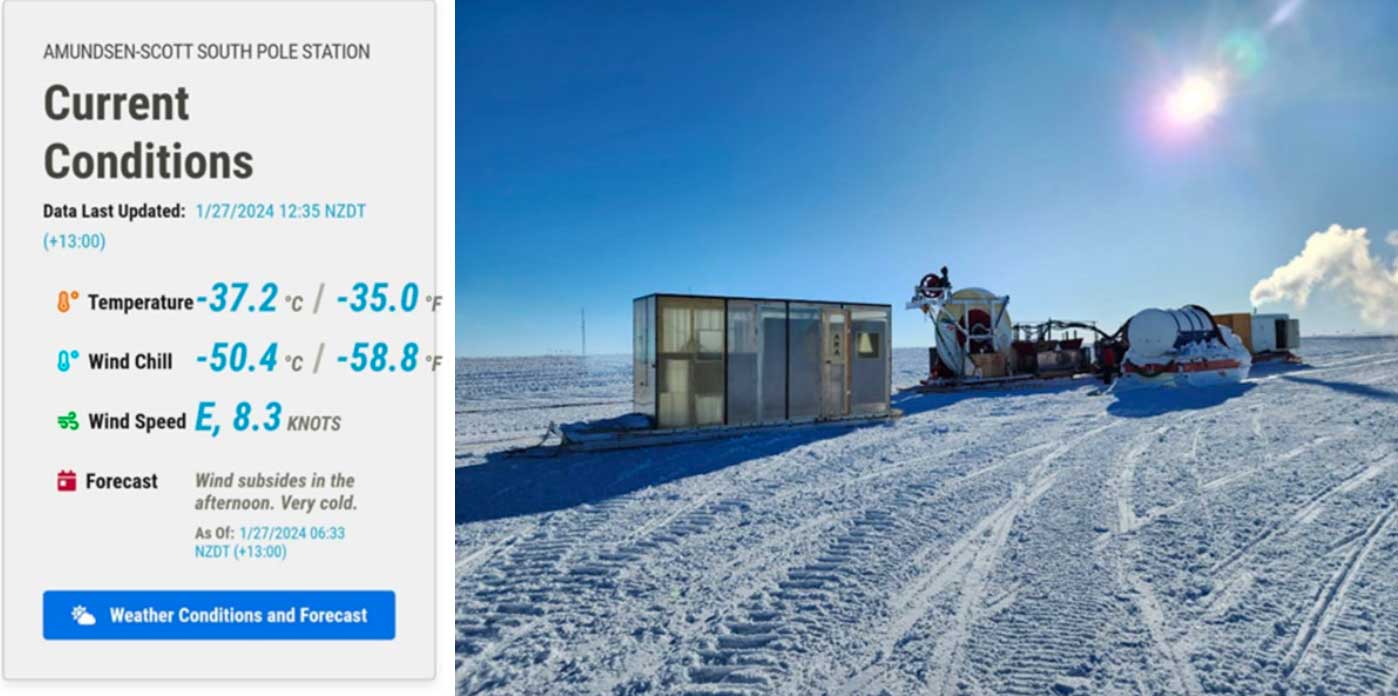

The ARA drill in position at the temporary "Intermediate Sewer" site at the station. The first 120 feet was drilled in December with the firn drill...the ARA drill completed the hole to about 250 feet, in late January in the weather conditions shown. As things kept icing up, a temporary warming tent had to be fashioned around the drill.

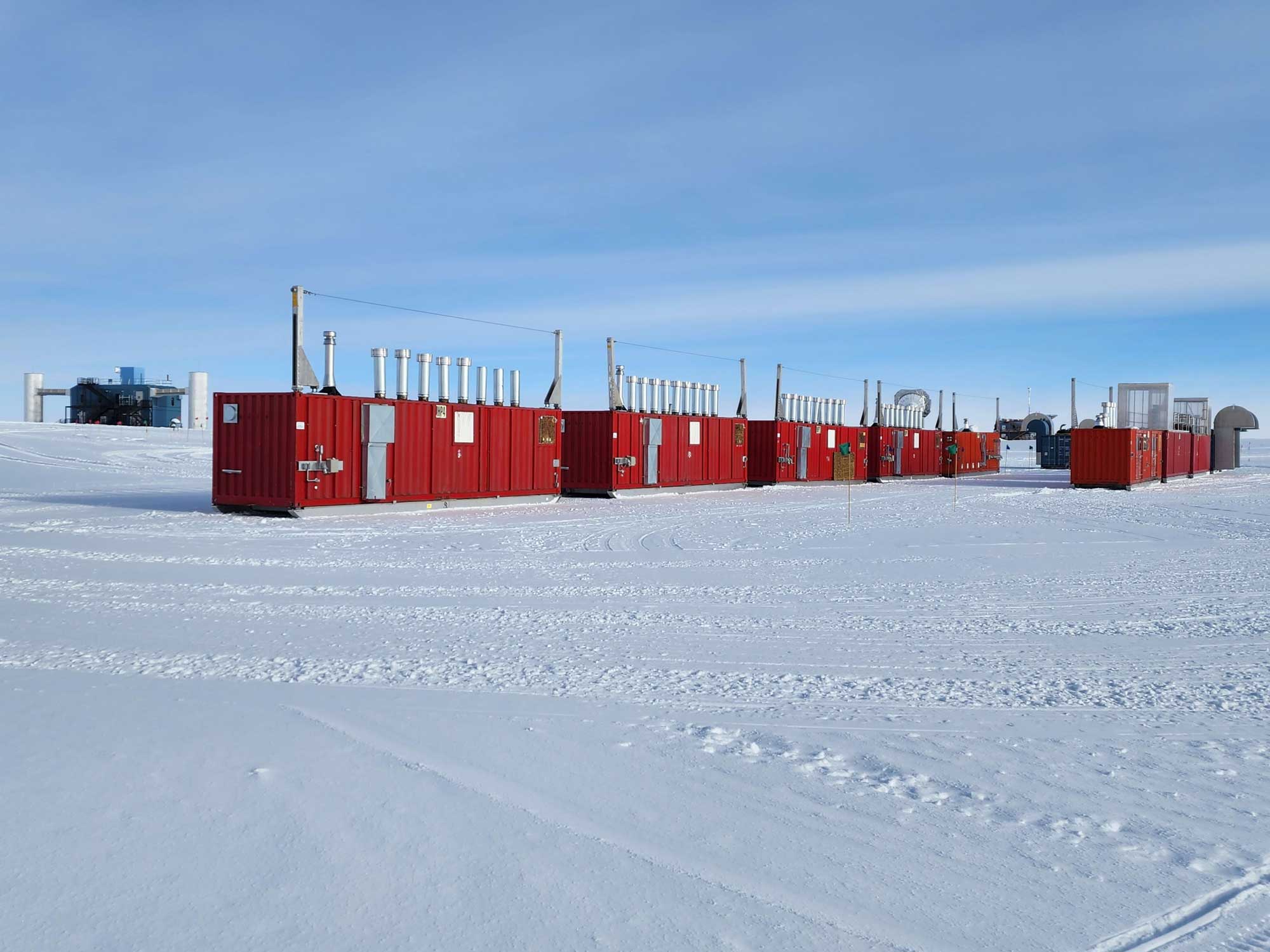

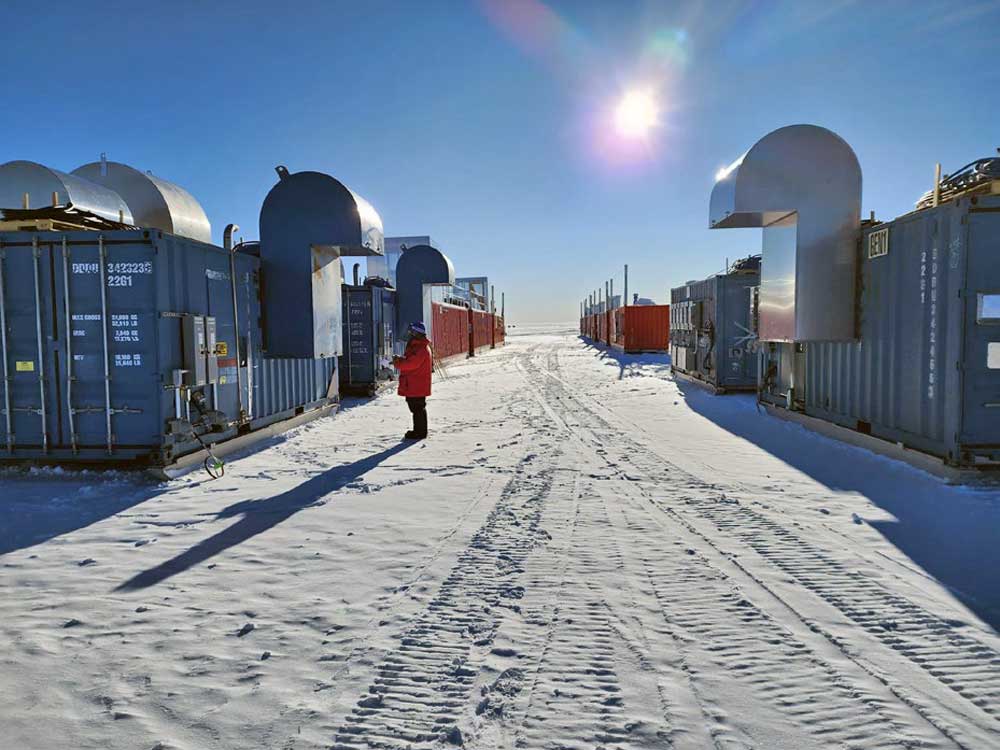

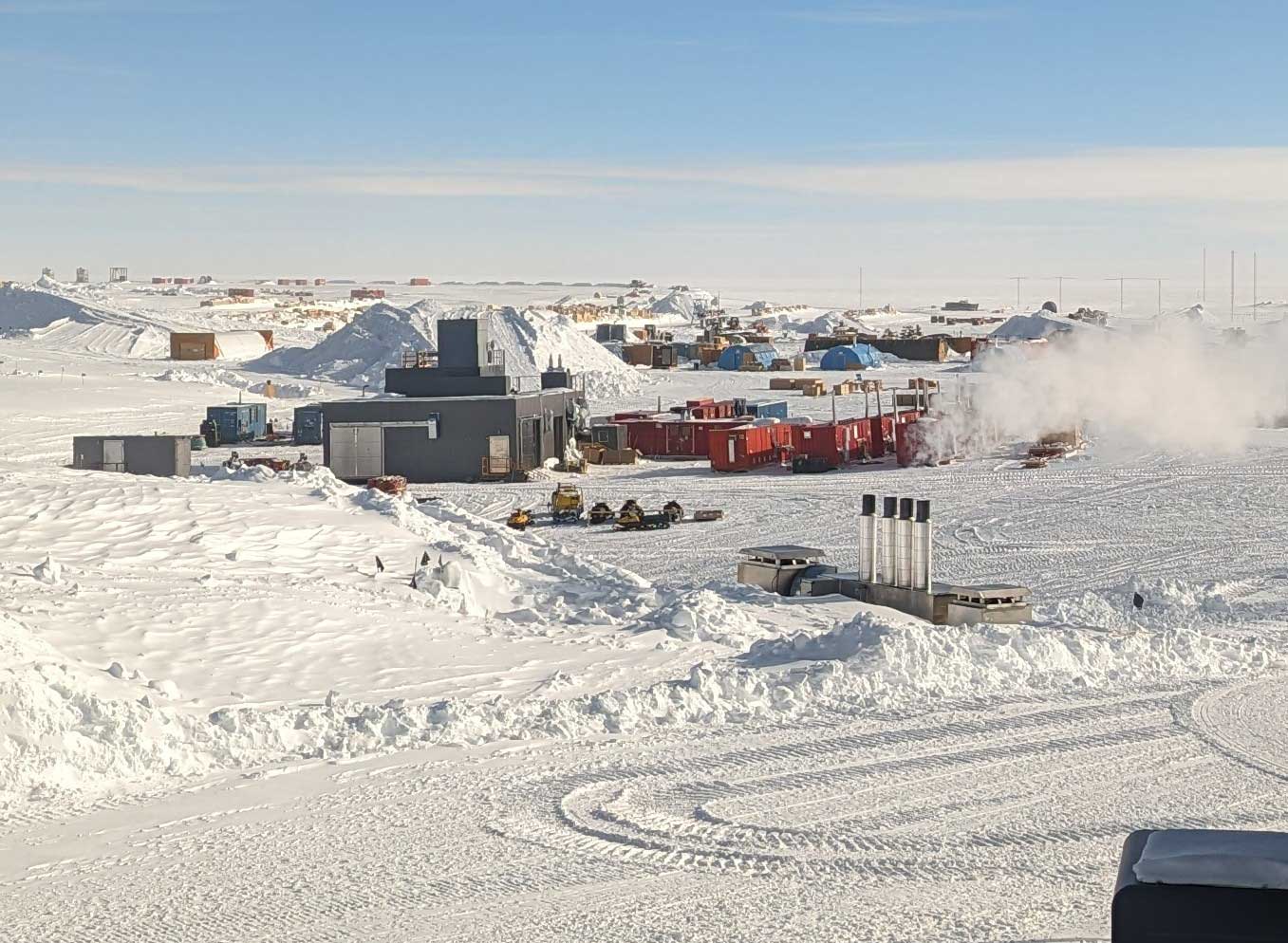

generator modules at the SES


As the season came to a close, configuration of the Seasonal Equipment Site was completed, structures were winterized, and critical components were removed to "do not freeze" storage. At left, a view of the SES showing the generator modules with hoods installed in the foreground, with water tanks and main heating plants in the distance. Also placed here was a warmup shack which had been constructed for IceCube by Pole station personnel.

All of the remaining personnel left Pole on 9 February and continued north from McMurdo a week later.


Some of the above information and additional details can be found in this public IceCube report which was posted on 1 February 2024.

Also, some of the original design details for the IceCube Upgrade and the rest of the forthcoming IceCube Gen2 can be found in this 2019 paper "Neutrino astronomy with the next generation IceCube Neutrino Observatory".
